Residential Pickleball Court in Amravati, Maharashtra

|Mukesh Jajodia, Founder, ChampCourts
Bare unsurfaced ground at the Amravati house before base construction — a flat dusty platform bounded by the property wa

Updated August 2026 · Amravati, Maharashtra

A private pickleball court at a home in Amravati, Maharashtra: an M20 PCC base finished with our 8-layer acrylic system, marked to the USA Pickleball 44 × 20 ft layout and screened on three sides. Acrylic runs ₹65/sqft onwards over a ₹90/sqft base, ex-GST, indicative. Get a free itemised estimate →

What did ChampCourts build at this house in Amravati?

One outdoor pickleball court in the yard of a private house in Amravati, Maharashtra. A plain cement concrete base, our 8-layer acrylic system over it, regulation line marking, and a green screen enclosure on three sides. The blue playing field, terracotta non-volley zones and green run-off are acrylic colour coats, not paint on concrete.

Delivered in 2026, one of our earliest builds that year, photographed from bare ground to finished surface. We do not publish the homeowner's name. This is a family's yard, not an institution.

The playing rectangle is fixed by the rules and does not shrink. 44 × 20 ft, a 7 ft non-volley zone on each side of the net, the net set at 36 in over the sidelines and 34 in at the centre. Players call that zone the kitchen. What changes from site to site is the apron of run-off around that rectangle. This court's area is not recorded in our project register, so we will not quote one. A pickleball court laid out with full run-off measures 60 × 30 ft, or 1,800 sqft, and that is what we plan against when a plot allows it. The same household later came back to us for an indoor badminton court, which is the clearest verdict on the first one we have.

Where does a pickleball court fit on a house plot?

Against whatever the plot gives you. The 44 × 20 ft playing rectangle is non-negotiable. The run-off around it is what gets negotiated with the boundary wall, the driveway and the house itself. Plan for 60 × 30 ft where the land allows, and expect the tight side to stay tight.

Every build opens with a survey: plot measurement, levels, drainage fall and access for material movement. On a domestic plot that survey is mostly about subtraction. Here the court sits hard against the house wall on one long side, the screen enclosure carries the other three, and the run-off is set by the property boundary rather than by an ideal drawing.

30 × 60 ft is the working minimum footprint for one court. 34 × 64 ft is what we prefer where competitive play matters, because it buys a comfortable chase behind the baseline. Go below the minimum and you are compressing run-off, which is a decision to take deliberately at survey stage rather than discover at handover. Access matters as much as area. Sand, aggregate, cement and drums of acrylic all have to reach the pour, and on a house plot the only route in is often the gate.

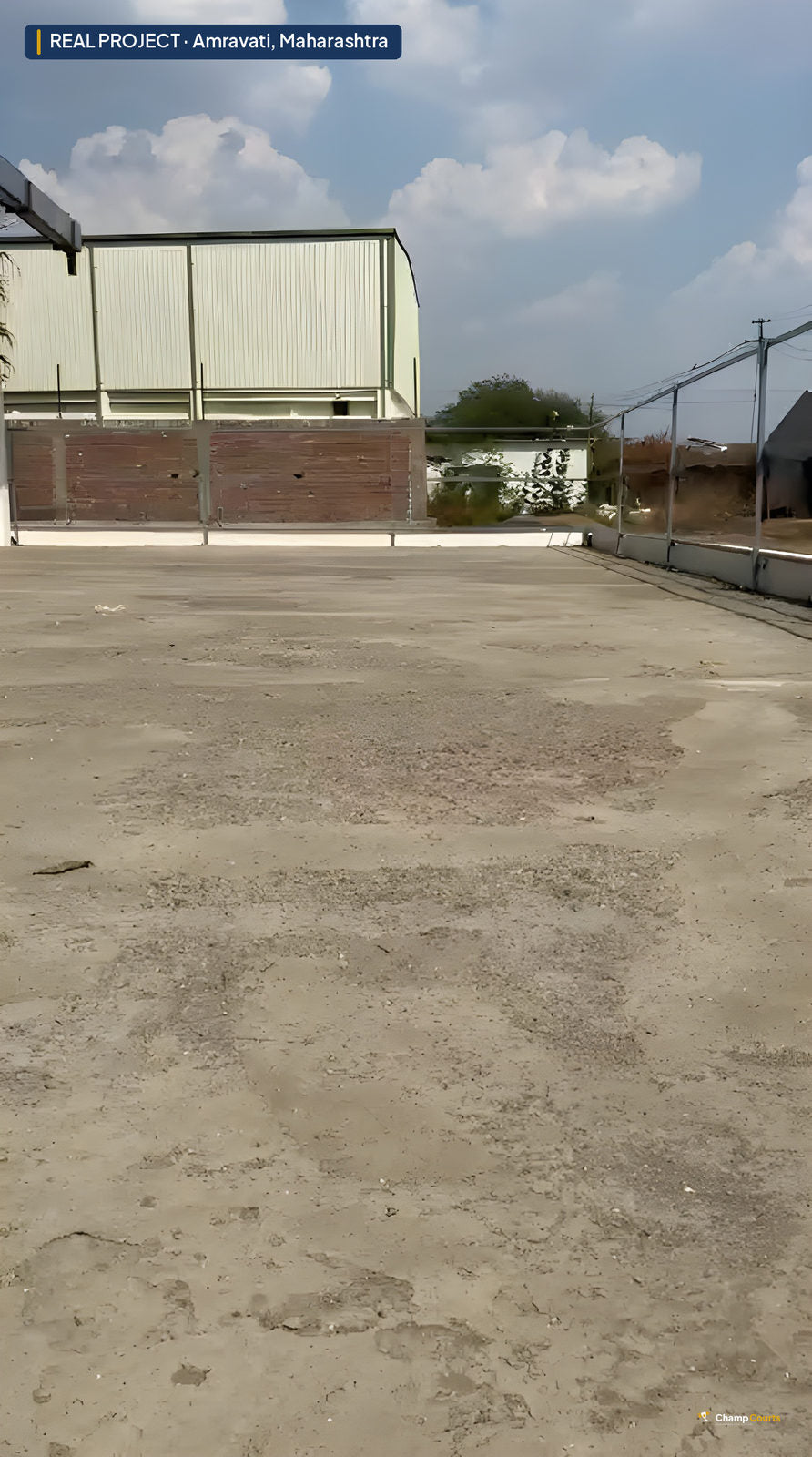

Bare unsurfaced ground at the Amravati house before base construction — a flat dusty platform bounded by the property wall and railing, with a shed behind
Site before: the flat, dusty, unsurfaced ground where the court would go, bounded by the property wall and railing. Nothing has been built yet. REAL PROJECT · Amravati

Why acrylic on a home court rather than tiles or turf?

Because pickleball is a hard-court game and acrylic gives one continuous surface with no joints, no seams and nothing to lift. The three cushion coats inside the 8-layer system take load off knees and ankles, and the colour lives in the coats rather than in a film on top of them.

This is a bonded system rather than a paint job. Primer soaks into the concrete. Two resurfacer coats fill micro-cracks and level the slab, three cushion coats absorb impact and settle the bounce, and two pigmented colour coats carry the UV resistance. It is warranted for 2 years, has a 5–7 year working life, and gets recoated rather than replaced at the end of it.

PP interlocking tiles are a real alternative. They lay fast, they drain through, and they can be lifted and relocated if the family moves. They also carry a perimeter that acrylic does not: kerbs run at four per foot of perimeter, half male and half female, plus four corner pieces. On a 60 × 30 ft court that is a 180 ft perimeter, 720 kerbs and 4 corners, all as separate priced lines. An acrylic court has none of that. For an outdoor home court in daily family use we lead with acrylic. The ITF guidance on hard-court construction sets out the wider engineering case.

How is the base built, and why does it wait 28 days?

The base is M20 plain cement concrete on a compacted granular sub-base, poured to a single falling plane and saw-cut into panels of roughly three metres. Then nothing happens for 28 days. That wait is not padding in the schedule. Skipping it is the single most common cause of acrylic failure.

Concrete keeps giving up moisture long after it looks dry. Acrylic laid over a slab that is still green traps that moisture underneath and blisters, and a blistered court cannot be patched. It has to be stripped back and redone. So we hold a minimum 28-day cure before any acrylic goes down, plus a sheet moisture check on the slab. The wet-curing regime follows IS 456:2000, and the 28-day gate before surfacing matches the SAPIA court construction specification.

Drainage is settled at the same time, before the pour rather than chased afterwards. The slab falls in one continuous plane at about 1:100. Never crowned in the middle, because a crown puts water on both halves of the court instead of taking it off one edge. Standing water is what kills an acrylic surface early. Not play.

The finished PCC base at the Amravati home with white surface priming compound applied in patches, green perimeter screen on a low white plinth wall behind
Base prep: the cured PCC base with surface priming compound applied in patches, ahead of the acrylic coats. The green perimeter screen is already up on its plinth wall. REAL PROJECT · Amravati

What do the eight acrylic layers actually do?

One primer, two resurfacer coats, three cushion coats and two colour coats: eight in total, in that order. Line marking follows as a finishing step and is not counted among the eight. Each coat is pulled by hand and left to cure before the next one goes on, which is why weather governs the schedule.

The primer absorbs into the concrete and seals its pores, so everything above it has something to bond to. The two resurfacer coats fill micro-cracks and level out the imperfections every slab has, which is what produces the flat plane the game needs. Then the cushion coats. Three of them, and they are the comfort layer: less joint fatigue, and a bounce that stays consistent across the whole court. They are also what separates this system from a five-layer economy build, which drops them entirely and costs less for exactly that reason. The last two coats are pigmented and UV-resistant. They are the part you actually see.

Lines come last, masked and painted at 2 in width to the USA Pickleball official rules layout once the final colour coat has cured. Seven acrylic colours are available. This court took a blue field, Terracotta Red non-volley zones and a green run-off.

An applicator pulling a terracotta acrylic colour coat with a hand squeegee across the cured grey resurfacer at the Amravati pickleball court
Laying: the terracotta colour coat pulled by hand with a squeegee across the cured grey resurfacer. Every coat on this court went down the same way. REAL PROJECT · Amravati

Specification strip — what this court is made of

Element Specified Note
Sport & layout Pickleball — 44 × 20 ft playing area, 7 ft non-volley zone each side USA Pickleball / IFP dimensions
Surface 8-layer acrylic: primer + 2 × resurfacer + 3 × cushion + 2 × colour Line marking is the finishing step, not one of the eight
Base M20 plain cement concrete on a compacted granular sub-base Unreinforced; crack control comes from joints, not steel
Cure gate Minimum 28 days before any acrylic, plus a sheet moisture check Skipping it blisters the surface irreparably
Drainage Single falling plane, about 1:100 Never crowned — standing water destroys acrylic
Colours Blue field · Terracotta Red non-volley zones · green run-off 7 acrylic colours available
Court area Not recorded for this site Full run-off footprint is 60 × 30 ft = 1,800 sqft; playing area 44 × 20 ft = 880 sqft
Kerbs & corners None Kerbs are a PP tile item — perimeter × 4, plus 4 corners. Acrylic courts carry none
Enclosure Green screen on three sides with a gate Quoted separately from the per-sqft surface rates
Timeline 28-day cure, then roughly 2–3 weeks of coating in dry weather Weather-dependent; monsoon stops coating
Warranty & life 2-year warranty · 5–7 year lifespan · recoatable Recoating point advised per site, not fixed
Indicative rate Acrylic ₹65/sqft onwards + PCC base ₹90/sqft Ex-GST. Indicative — final cost depends on site condition, location and scope

What about the neighbours — stray balls, noise and privacy?

The enclosure handles balls and privacy. The surface does not handle noise, and nothing we sell changes that. This court is screened on three sides with a gated green screen, which keeps the ball inside the property and keeps the court out of view from the windows around it.

Be clear-eyed about sound. Pickleball is a loud game. The pop of a paddle on a hard ball is the sport's signature, and no acrylic system quietens it. What a homeowner does control is geometry and habit: how far the court sits from the boundary, whether a solid screen or wall stands between the play and the nearest neighbour, what hours the family plays. Settle those at survey stage, when moving the court five feet still costs nothing.

Evening play is a separate line item. Where floodlights are specified we mount them on both long sides of the court, symmetrically, and never behind the baselines. A light on a baseline shines straight into the server's eyes. Lighting, net posts and the net itself are all quoted apart from the per-sqft surface rates.

Ground-level view of the finished residential pickleball court in Amravati — blue playing field, terracotta non-volley zones, white lines, green run-off, green screen enclosure and the house wall alongside
Finished: the completed court from ground level — blue field, terracotta non-volley zones, 2 in white lines and a green run-off, with the screen on one long side and the house wall on the other. REAL PROJECT · Amravati

What does a home pickleball court cost to build?

The surface and its base run at ₹65/sqft onwards for the 8-layer acrylic plus ₹90/sqft for the PCC base, about ₹155/sqft onwards combined, ex-GST. On a full 1,800 sqft footprint that is roughly ₹2.79 lakh onwards before GST. These are indicative: final cost depends on site condition, location and scope.

That figure covers the base, all eight acrylic layers and the regulation line marking. It does not cover earthwork and levelling if the ground needs it, the screen or fencing, net posts and net, floodlighting, or any boundary and drainage work the site forces. Insist on seeing every one of those as its own line on any quote you are given. GST at 18% is extra on all of it.

Two things move the number more than anything else on a domestic plot. One is what is under the court today, because a sound existing slab is a different job from filled or made-up ground. The other is access: material that cannot be driven in has to be carried in. Both are settled at survey. That is why we quote itemised, so you can question the estimate line by line rather than argue with one number. Payment is staged against the build and set out in the estimate.

What does a family actually get for the money?

A regulation court a few steps from the door, in a colour scheme they chose, that plays the same in year three as it did in week one. Two-year warranty, a 5–7 year working life, and a surface that gets recoated rather than replaced when it eventually wears.

Upkeep is deliberately undemanding, which matters when the owner is a family rather than a facilities team. Clean it with plain water. No detergents, no chemicals. Let it dry an hour or two after rain before anyone plays, keep spiked and hard-soled footwear off it, and do not drag heavy or sharp things across it. A periodic mild wash keeps the surface playing consistently. We advise on the right recoating point for the site rather than selling a fixed interval.

The honest measure of whether a residential court gets used is whether the household buys another one. This one did: the same family returned to ChampCourts for an indoor badminton court, built for play out of the sun and rain. Get a free itemised estimate for your own site →

Elevated view of the finished Amravati pickleball court within the property — blue and terracotta court inside a dark green screen enclosure with a gate, set alongside the house
Finished, in context: the court seen from an upper floor of the house — screened on three sides, gated, and set directly alongside the building it belongs to. REAL PROJECT · Amravati

FAQ

How much space do I need for a pickleball court at home?

The playing area is 44 × 20 ft, with a 7 ft non-volley zone on each side of the net. Plan a 30 × 60 ft footprint as the working minimum for one court, and 34 × 64 ft if you want comfortable run-off behind the baselines. Below 30 × 60 ft a court is still buildable, but you are compressing the run-off, and that trade-off should be made knowingly at survey rather than discovered later.

How long does it take to build a court at a house?

On a new PCC base, plan roughly seven to eight weeks from the pour: a minimum 28-day cure before any acrylic touches the slab, then about two to three weeks of coating, because each of the eight layers has to cure in dry conditions before the next goes on. On a sound existing slab the cure gate disappears and only the coating window remains. Monsoon rain stops coating outright, so the survey sets a site-specific timeline.

Will a pickleball court be too noisy for my neighbours?

Pickleball is a loud game and the acrylic surface does not change that — the noise comes from the paddle striking the ball. What you can control is the distance between the court and the boundary, whether a solid screen or wall sits between them, and the hours the family plays. We would rather settle those at survey stage, when shifting the court a few feet is free, than have the conversation after the court is down.

Can I play on the court in the monsoon?

You can play once it is dry. Acrylic is a non-porous surface laid to a single 1:100 falling plane, so water runs off rather than pooling; allow an hour or two after rain stops before anyone goes on. What the monsoon genuinely blocks is construction, not play — acrylic coats cannot be applied in wet conditions, so a build scheduled into the rains will stall between layers.

What maintenance does an acrylic court need?

Very little. Wash with plain water only — no detergents, no chemicals, nothing abrasive. Keep spiked and hard-soled footwear off it and avoid dragging heavy or sharp objects across the surface. A periodic mild court wash keeps the playing characteristics consistent. The system is warranted for 2 years with a 5–7 year working life, and it is recoated rather than replaced at the end of that; we advise the right recoating point for your site instead of quoting a fixed interval.

Can the same court carry lines for another sport?

Yes. Line marking is the finishing step over the acrylic colour coats, so one footprint can carry more than one set of lines in contrasting colours — pickleball plus badminton is the common domestic pairing. The constraint is area, not paint: each sport has its own regulation rectangle and its own run-off, so the layouts have to be drawn together at design stage rather than added to a finished court.

Want a Court Like This?

Tell us about your space, your sport, and your timeline. We'll send you a detailed estimate within 48 hours — completely free.

  • Free estimate — no commitment
  • Written quote within 48 hours
  • Turnkey delivery across India

Prefer to call or WhatsApp?

Get Your Free Estimate

We respond within 24 hours. No spam, no pressure.
