Twin Pickleball Courts, Sivakasi — Build Story

|Mukesh Jajodia, Founder, ChampCourts
Bare red-earth plot in Sivakasi set out with string lines, stockpiles of grey aggregate along the boundary wall before b

Updated August 2026 · Sivakasi, Tamil Nadu

ChampCourts built twin pickleball courts in Sivakasi, Tamil Nadu. That is 3,600 sqft of 8-layer acrylic over an engineered WMM and asphalt base, inside a floodlit netting enclosure. We photographed the build stage by stage. At our published band an acrylic court runs Rs 180–200/sqft ex-GST, indicative. Get a free itemised estimate →

What did ChampCourts build in Sivakasi?

Two full-size pickleball courts on one long plot, 3,600 sqft between them. The surface is 8-layer acrylic. Under it is an engineered wet-mix macadam and asphalt base, not concrete. The whole thing sits inside a green steel and ball-stop netting cage, floodlit down both long sides and marked to USA Pickleball geometry.

Each court occupies 1,800 sqft. Only 880 of that is marked surface — the USA Pickleball rulebook puts the playing court at 44 × 20 ft — so the other 920 sqft per court is run-off: about 8 ft behind each baseline, 5 ft down each side. The plot here is long and narrow. That settled the layout for us. The two courts run end to end with a net between them, and the full 3,600 sqft is caged as one arena instead of two fenced boxes. The client is a private owner and the job completed in 2026. We hold 54 photographs of this build that are ours to publish, and 38 of them are of the surfacing alone, which is why the story below goes coat by coat instead of ending on one finished picture. No renders anywhere on this page.

Why does this court sit on an asphalt base instead of concrete?

Because the site was built like a road, not like a slab. A compacted subgrade, a wet-mix macadam layer and a hot-mix asphalt wearing course give a jointless, slightly flexible pad. Concrete would have needed control joints and a 28-day cure before any acrylic could be applied.

Our default acrylic specification calls for a PCC M20 base over 70 mm of granular sub-base, fully cured for 28 days before any coating starts. Concrete also needs control joints. Joints move, and they telegraph through an acrylic system as fine cracks within a few seasons. A rolled asphalt pad has no joint anywhere in the 3,600 sqft, and it flexes with seasonal ground movement instead of fighting it. It gets the same single-plane slope of 1–1.5% we set on every acrylic court, so rain sheets off one way and does not pond at mid-court, and it follows the layer logic set out in the MoRTH Specifications for Road and Bridge Works. Our product registry rates an asphalt base at a 15-year service life. Both bases work. On this plot, in this climate, asphalt was the better-behaved answer.

Why acrylic for pickleball, rather than interlocking tiles?

Pickleball is a hard-court game. Acrylic is a seamless, bonded coating with no joints anywhere in the playing area, so the ball behaves identically wherever it lands. Interlocking tiles are a genuinely good product. They are just the wrong product for a competition-feel pickleball court.

An acrylic system goes down as a liquid, coat by coat, and cures into a single sheet. Its pace and grip come from the grade of silica sand carried in the top two colour coats. That is the same principle behind the ITF court pace classification for tennis surfaces, and it is why a hard court can be tuned slow or fast without changing what it is made of. Interlocking polypropylene tiles snap together on a grid. They drain fast, install quickly, and earn their place on terraces and school multi-sport pads. But the grid is present in every bounce. Pickleball at ChampCourts is an acrylic-led product for that reason. The three rubberised cushion coats inside the 8-layer system are what give it shock absorption, the property EN 14904 defines and measures for indoor multi-sports surfaces, and the vocabulary most buyers have already met. Tiles also need perimeter kerbs and corners. An acrylic court needs none. It has no edge to protect.

How is the base built before any acrylic goes down?

In four moves: strip and level the red-earth plot, set out and compact a granular layer, spread and roll a hot-mix asphalt wearing course, then leave the pad alone. The photographs below run in that order. None of it is court work. All of it is civil engineering.

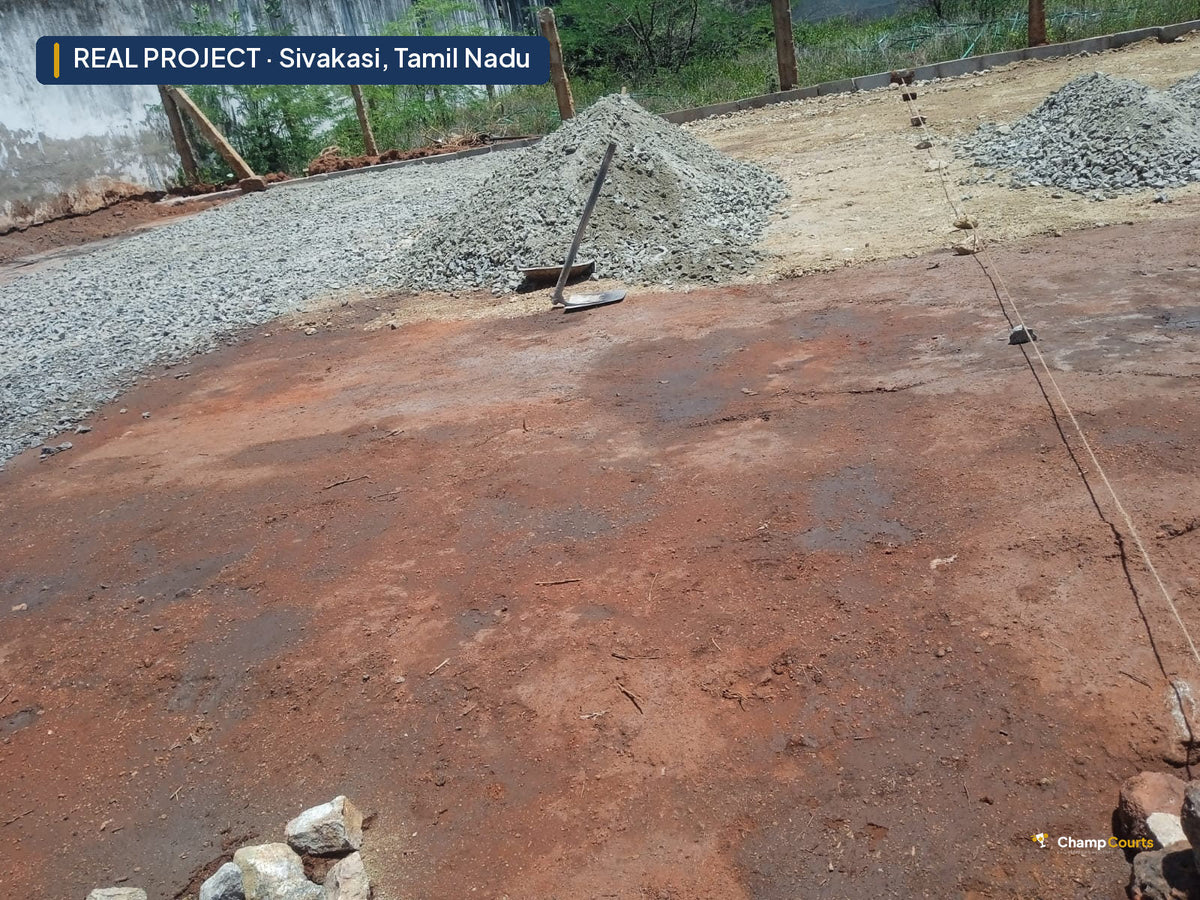

Bare red-earth plot in Sivakasi set out with string lines, stockpiles of grey aggregate along the boundary wall before base work
REAL PROJECT · CHALISGAON the plot before anything was built: red earth graded flat, a string line pegged across it to set out the court, aggregate stockpiled against the existing compound wall. The edge beam along the far side is already cast.

The court is set out with string lines against the existing compound wall. Aggregate is stockpiled inside the plot before work starts, because on a site this size there is nowhere else to put it. Then a compacted subgrade, a granular layer, and the bituminous course spread hot and rolled while it is still workable.

What the pad does here decides what the court can be later. It has to hold a single-plane fall of 1–1.5%, so that water runs off one way instead of sitting in the middle of a court. And it has to come out closed and even. An acrylic system is roughly 3 mm thick in total; it will not level anything the base got wrong. Whatever dip or high spot the pad carries, the finished court carries too. A sand-filled resurfacer coat fills micro-cracks. It does not fill a hollow you can see from the baseline.

Crew spreading hot asphalt by hand with rakes across the pale aggregate base of the Sivakasi court, half the width laid black
REAL PROJECT · CHALISGAON hot mix spread by hand with rakes, one rake-width at a time. The pale aggregate on the left is the layer being covered; the black on the right is the wearing course going down.
Ride-on road roller compacting freshly laid black asphalt on the Sivakasi pickleball court base, crew working alongside
REAL PROJECT · CHALISGAON a ride-on roller compacting the fresh mix. This is the moment the pad gets its density; the blue site wall in the background is the neighbouring boundary.
Completed asphalt base pad for the twin pickleball courts in Sivakasi, green shade netting along one side, dust-grey surface
REAL PROJECT · CHALISGAON the finished pad, seen down its long axis. The black asphalt edge is visible against the green shade netting on the right; the field has dusted pale grey. Nothing is coated yet.

Does the steel enclosure go up before or after the surface?

Before. The posts are set into the base and painted while the pad is still bare, so no one is welding, drilling or dropping primer onto a finished acrylic surface later. By the time the first coat is pulled, the crew is working inside a finished cage.

Green steel enclosure post standing braced on the bare asphalt base beside the sheet-metal boundary at the Sivakasi court
REAL PROJECT · CHALISGAON a perimeter post set and temporarily braced on the bare base, against the new sheet-metal boundary. The trees behind mark the plot edge.
Enclosure post being painted at night by lamplight, red-oxide primer above and green finish coat below, on the black asphalt base
REAL PROJECT · CHALISGAON the same steel being painted after dark: red-oxide primer on the upper half, green finish coat coming up from the bottom. The base underneath is still fresh black asphalt.

On a pickleball court the enclosure is playing equipment. It keeps the ball in play and off the road, and it carries the floodlights. The netting is ball-stop mesh, tensioned on a perimeter border rope and laced continuously to the frame. Hang it off a handful of tie points instead and the load concentrates there; the net sags inside a season. The cord is UV-stabilised, and nothing ferrous sits against the mesh. Lights go on the frame along both long sides, never behind the baselines, because a light on the baseline sits directly in the receiver's eyeline. Putting the steel up first also means the paint, the primer overspray and the concrete around each post base are all finished long before the acrylic arrives. Surface first and fabricate afterwards, and a brand-new court picks up weld spatter and boot-dragged primer in its first week.

What do the eight acrylic layers actually do?

One primer, two resurfacer coats, three cushion coats, two colour coats. Eight in all, about 3 mm of dry film. Line marking is a ninth operation but is not counted in the eight. Six of those coats are grey or black, which is why 31 of our photographs show a court that looks unfinished.

Sealed dark base of the Sivakasi pickleball court photographed at night inside the completed green steel enclosure
REAL PROJECT · CHALISGAON the sealed pad at night, inside the finished enclosure and before colour. A ladder is still against the frame; the floodlights are already mounted and working.

The primer soaks in and seals the base, so the coats above bond to one surface instead of to loose fines. Levelling is the resurfacer's job: two sand-filled coats that fill micro-cracks and flatten the imperfections a rolled pad always carries. Then the cushion. Three rubberised coats, no sand in them at all, and they are what a player's knees actually feel. They steady the bounce too. Only the last two coats carry pigment, and the grade of silica sand in those two sets the pace and grip of the finished court. Each coat has to cure before the next one is pulled, which is why eight layers is a programme and not an afternoon. It is also why an 8-layer court and a 5-layer court look identical on handover and behave differently three years later. The five-layer system keeps the primer, both resurfacer coats and both colour coats, and drops the three cushion coats entirely, about 1.5 mm out of the 3 mm build.

Grey acrylic levelling coat covering the full width of the Sivakasi court in daylight, squeegee working marks still visible
REAL PROJECT · CHALISGAON a grey coat covering the full width in daylight. The sweeping marks are the squeegee's working pattern in material that has not yet flowed out; they disappear as the coat levels and dries.

Why was so much of the coating pulled after dark?

Southern Tamil Nadu heat. Acrylic pulled onto a pad baking in the afternoon sun skins over before it has flowed out, which leaves lap marks and an uneven film. Working at night, or early before the surface heats, gives the material time to level itself.

Grey acrylic coat being applied at night under floodlights on the Sivakasi court, netting enclosure and boundary sheeting behind
REAL PROJECT · CHALISGAON a grey coat going off at night under the court's own floodlights, which were already mounted and working while the surfacing was still in progress.

A clear run of the 38 surfacing photographs in this set were taken after dark, under work lamps and the court's own floodlights. Nobody chose that for the look of it, and no stock photograph would ever show it to you. It has a practical consequence worth knowing before you sign a contract in a hot district: the crew's day runs off the surface temperature, not the clock. A coat may go down late in the evening and the next one at first light.

The other thing the photographs show is that there is no machine anywhere in the surfacing sequence. One applicator. One squeegee. One pull at a time, across 3,600 sqft, eight times over. That is the labour standing behind a rate quoted per square foot, and it is worth holding in mind when two quotations are compared on rate alone. What usually separates them is how many coats are in the system, not how fast a crew can work.

Sivakasi twin pickleball courts at night with wet green surround, blue field and terracotta zone under floodlights before line marking
REAL PROJECT · CHALISGAON colour, at night and still wet: green surround, blue field, terracotta zone, both courts visible running away from the camera. No lines yet.

How do two courts get their colour and their markings?

Colour goes on in zones, not all at once. Surround first, then the field, then the contrasting zone, each colour masked against the last. Line marking comes afterwards as a separate operation, set out by tape and measurement to USA Pickleball geometry, and is not one of the eight layers.

Applicator pulling blue acrylic colour coat across the grey Sivakasi court surface with a rubber-bladed squeegee
REAL PROJECT · CHALISGAON the blue colour coat pulled across the grey with a rubber-bladed squeegee. The wet edge on the left is the boundary between what is coated and what is not; it has to be kept moving.
Worker rolling a second blue acrylic colour coat on the Sivakasi pickleball court, green surround and terracotta zone already laid
REAL PROJECT · CHALISGAON a blue coat being worked with a roller, with the green surround and the start of the terracotta zone already down around it.
Terracotta acrylic zone laid between the two blue halves of the Sivakasi pickleball court, wet and freshly finished
REAL PROJECT · CHALISGAON the terracotta band laid last, between the two blue halves, still wet. The straight colour boundaries are masked, not freehand.

Three of our seven standard acrylic colours are on this court: a blue field, a terracotta central zone, a green surround. They are picked so the ball reads against the court and the court reads against the run-off. Order matters. The surround is pulled first, because any overrun there gets covered later by the field; the contrasting zone goes on last, being the smallest and most exposed area. Line marking follows once the colour has cured. Lines are 2 in wide in the USA Pickleball layout and the non-volley zone runs 7 ft from the net on each side, so the setting-out is measured off the net line, never off the court edge. On a two-court build that setting-out is done twice, and checked against both courts, before any paint goes down.

What is the full specification of this build?

Two pickleball courts, 3,600 sqft, 8-layer acrylic on an engineered WMM and asphalt base, with a netting enclosure, floodlights on both long sides and full line marking. No kerbs. Those belong to interlocking tile courts. The table below is the specification as built.

Element As built in Sivakasi Note
Sport & courts Pickleball × 2, end to end USA Pickleball / IFP geometry
Total area 3,600 sqft 1,800 sqft per court with run-off
Marked playing area 44 × 20 ft = 880 sqft per court 8 ft baseline run-off, 5 ft side run-off
Base Compacted subgrade → WMM → hot-mix asphalt Jointless; 15-year base service life; 1–1.5% single-plane fall
Surface 8-layer acrylic, ≈3 mm dry film 1 primer + 2 resurfacer + 3 cushion + 2 colour
Colours Blue field, terracotta zone, green surround 3 of our 7 standard acrylic colours
Line marking Full pickleball markings, both courts Finishing step — not counted in the 8 layers
Enclosure Steel frame + ball-stop netting, full perimeter Rope-tensioned and laced; UV-stabilised cord
Lighting LED floodlights, both long sides Never behind a baseline
Kerbs & corners None Kerbs apply to PP interlocking tile courts, not acrylic
Warranty / life 2-year warranty, 5–7 year surface life Product default for the 8-layer system

Four rows in that table are where quotations quietly diverge, so compare those four line for line. Coat count first. A 5-layer system is a legitimate product and we sell it, but it is not this court, and a quotation that says only "acrylic coating" has not told you which one you are buying. Then the base, because "base included" can mean anything from a compacted subgrade to a full WMM and asphalt build. Then run-off: a court quoted at 880 sqft is a marked area, not a buildable footprint. The enclosure last, and it is the line most often missing altogether. On a pickleball court it stops the ball and carries the lights, which makes it equipment rather than a boundary.

What does a twin pickleball court like this cost?

At our published band, an acrylic pickleball court runs Rs 180–200/sqft all-in, ex-GST, covering base plus the 8-layer system. On a 3,600 sqft twin-court footprint that is roughly Rs 6.5–7.2 lakh ex-GST for the court itself. Enclosure and floodlighting are quoted separately.

Line Indicative rate (ex-GST)
8-layer acrylic coating Rs 65/sqft onwards
Base — PCC M20 with 70 mm GSB (our default) Rs 90/sqft
Base — engineered WMM + asphalt (as used here) Quoted per site — depends on subgrade, access and haulage
Acrylic court, all-in band Rs 180–200/sqft
Enclosure, netting, floodlighting Itemised separately per site

These are indicative bands, not a quotation. Final cost depends on site condition, location and scope, and GST at 18% is extra. We do not publish what any client paid. What we will give you is the same itemised sheet this project was priced from. Base, surface, markings, enclosure and lighting each sit on their own line, so nothing turns up later as an extra. On a build like this one the number moves mostly on what is already sitting on the ground: a plot that needs cutting, filling and haulage costs more than a plot that is already level. Court count moves it the other way. Setting out, mobilising a crew and getting material to a district like Sivakasi costs much the same whether you are building one court or two.

What did the client end up with?

A floodlit, fully enclosed twin-court arena that plays after dark. The base under it is jointless and rated for 15 years. The acrylic on top is about 3 mm, warranted for two years and rated to last five to seven. Both courts are marked to full USA Pickleball geometry.

Finished floodlit twin pickleball courts in Sivakasi at night, blue fields, terracotta non-volley zones and white regulation lines
REAL PROJECT · CHALISGAON the finished arena at night, both courts in line and fully marked. This is the same surface as the grey photographs above, eight coats later.
Finished Sivakasi pickleball courts in daylight seen from a corner, green surround, blue court, netting enclosure and floodlight pole
REAL PROJECT · CHALISGAON the same arena in daylight, from the corner. The second court is visible beyond the dividing net; the matte finish reads flat rather than glossy, which is what the sand in the colour coats is for.
Full-height view of the enclosed Sivakasi pickleball arena at night showing the netting cage and floodlights along both long sides
REAL PROJECT · CHALISGAON the full height of the enclosure, with the floodlight run along both long sides. The netting continues over the far court.

Maintenance on this surface is deliberately dull. Plain water, nothing else. No chemicals, no detergents. An hour or two of drying after rain before anyone plays. No spikes and no hard soles. Dust is the real variable in a district like this one, and a periodic wash is what keeps the pace of the court consistent: grit sitting on a sand-filled colour coat changes how the ball behaves. Recoating extends the life of the system. We quote that per site when the court is due, instead of promising an interval, because usage hours and climate are what decide it.

Planning a pickleball court in Virudhunagar district or the wider Madurai belt? Send us the plot dimensions and whether the ground is bare earth, an existing slab or asphalt, and we will come back with an itemised estimate. ChampCourts Private Limited builds sports courts pan-India from our Hyderabad HQ.

Get a free itemised estimate · WhatsApp us · Call 92587 75187 · enquiry@champcourts.com

FAQ

Can a pickleball court be built on an asphalt base instead of concrete?

Yes. The Sivakasi courts on this page are 8-layer acrylic over an engineered WMM and hot-mix asphalt base. Asphalt gives a jointless pad with no control joints to telegraph through the surface, and it does not need the 28-day cure a PCC M20 slab does before coating can start. Concrete remains our default specification and is the better answer on many sites. Which one suits your plot depends on the subgrade, drainage and access, and that is settled at the survey.

How much does a twin pickleball court cost in Tamil Nadu?

An acrylic pickleball court runs Rs 180–200/sqft all-in, ex-GST, covering base plus the 8-layer acrylic system, so a 3,600 sqft twin-court footprint lands around Rs 6.5–7.2 lakh ex-GST for the court itself. Enclosure netting and LED floodlighting are itemised separately. These are indicative bands rather than a quotation. The final cost depends on site condition, location and scope, and GST at 18% is extra. The free itemised estimate prices your actual plot line by line.

How long does an acrylic pickleball court take to build?

On a ready base, roughly two to three weeks, weather dependent. Each of the eight coats needs its own curing window before the next one goes on. Fresh base work adds laying and curing time before that. Sivakasi's dry heat helps the coats cure but pushes work into the night and early morning, and the northeast monsoon can stretch any schedule. We give you a site-specific programme after the survey rather than a standard number.

Is acrylic or PP interlocking tile better for pickleball?

Acrylic, for anything meant to play like a real court. It cures into one seamless sheet with no joints in the playing area, and the silica sand in the top two colour coats sets its pace and grip. PP interlocking tiles install faster, drain freely and suit terraces and school multi-sport pads, but the tile grid is present in every bounce, and tile courts need perimeter kerbs and corners that an acrylic court does not. We advise per site after the survey.

How do you maintain an acrylic court in a hot, dusty district?

Wash it with plain water only, no chemicals or harsh cleaners. Let the surface dry for an hour or two after rain before play. Use rubber-soled court shoes, never spikes or hard soles, and avoid dragging heavy or sharp objects across it. A periodic mild wash matters most where dust is constant, because grit on a sand-filled colour coat changes the pace. The 8-layer system carries a 2-year warranty and a 5–7 year surface life.

Want a Court Like This?

Tell us about your space, your sport, and your timeline. We'll send you a detailed estimate within 48 hours — completely free.

  • Free estimate — no commitment
  • Written quote within 48 hours
  • Turnkey delivery across India

Prefer to call or WhatsApp?

Get Your Free Estimate

We respond within 24 hours. No spam, no pressure.
